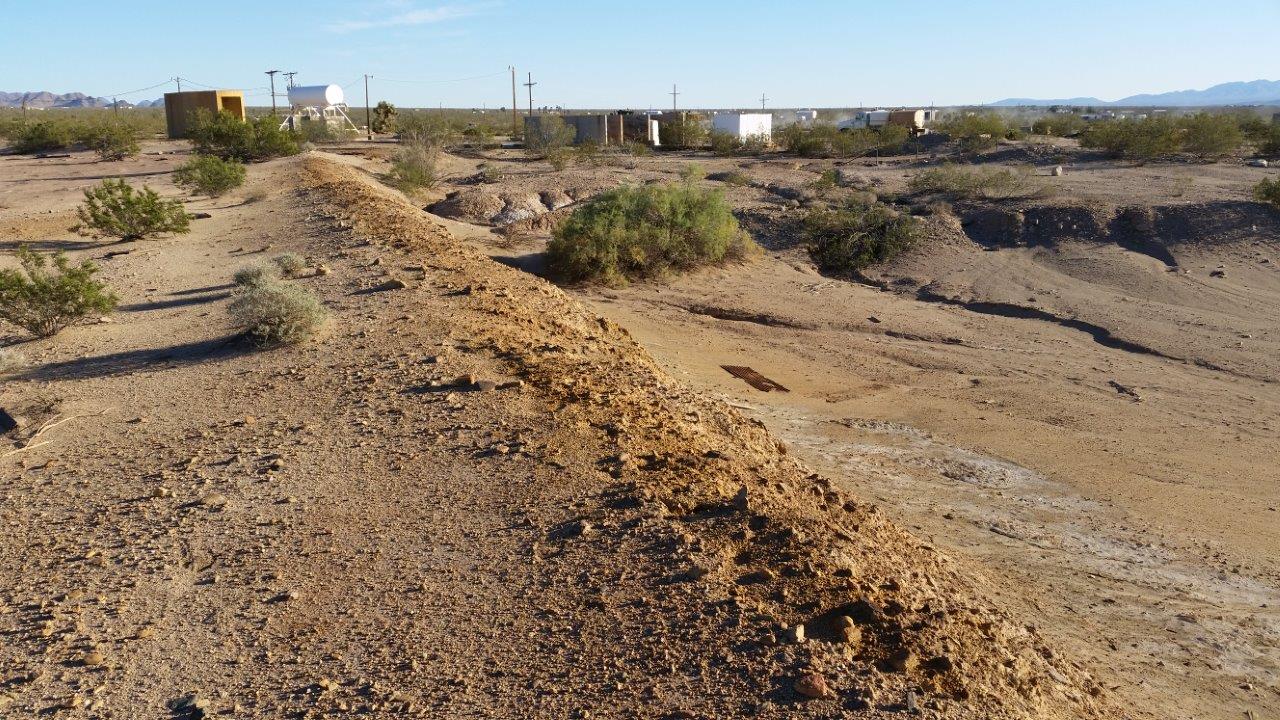

Mindy Mill ended operations in August, 1985. This abandoned mill site utilized jaw and cone crushers, a ball mill grinder, and flotation processes to process silver and lead materials.
This mill operated at about 425 tons per day, and processed silver ores sourced from the McCracken and Flag mines in the area as well as tungsten ores sourced from the Boriana mine.
Figure 1: Mindy Mill
Photo provided by Client
To determine any existing contaminants of concern for the site within the Site Investigation (SI), the team verified data through X-Ray Fluorescence (XRF) and Inductively Coupled Plasma (ICP) procedures.
This information has also allowed the team to assess for Resource Recovery.

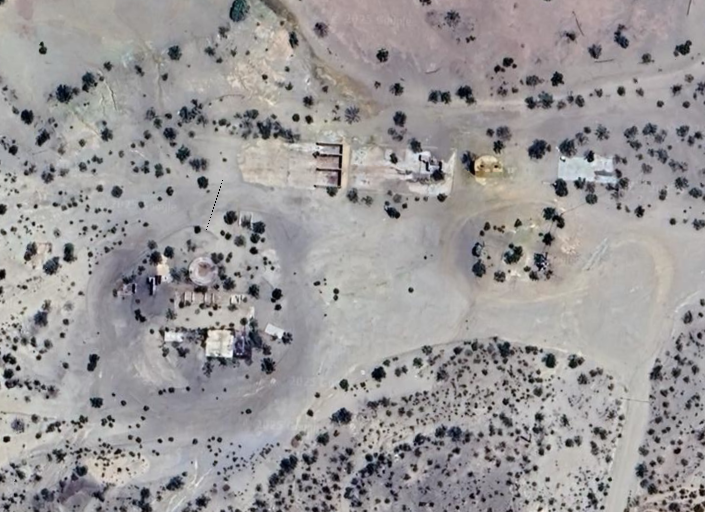

Figure 2: Mindy Mill Aerial
Photo sourced from Google Earth
Yucca, Arizona | Township 17 N Range 17 W Section 30 Quarter SW | Latitude: 34°49’15” N Longitude: 114°7’6” W
Figures 3-5 below display the Mindy Mill site location, the mines and towns in the vicinity, and the site itself including labelling of notable structures and washes around the site.

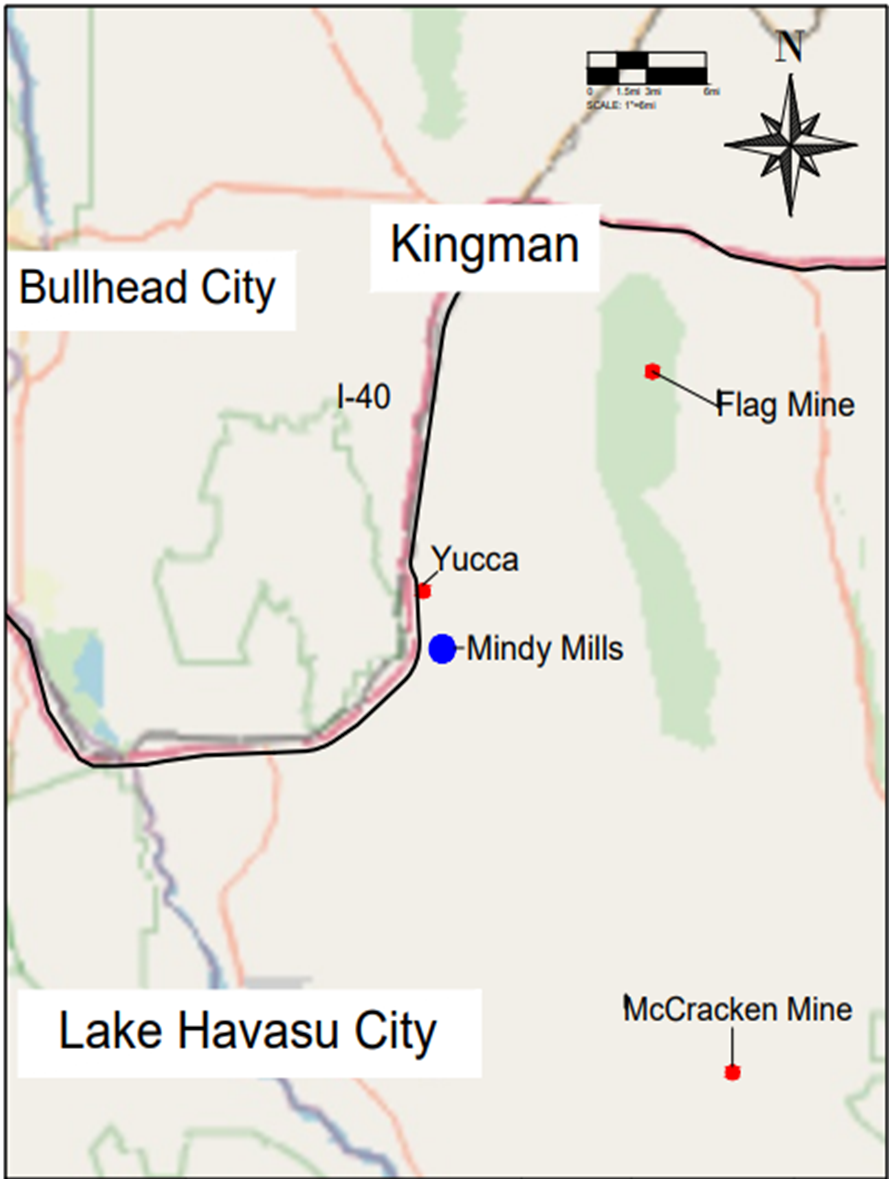

Figure 3: Location Map
Map sourced from Annika Dillemuth
Figure 4: Vicinity Map
Map sourced from Annika Dillemuth

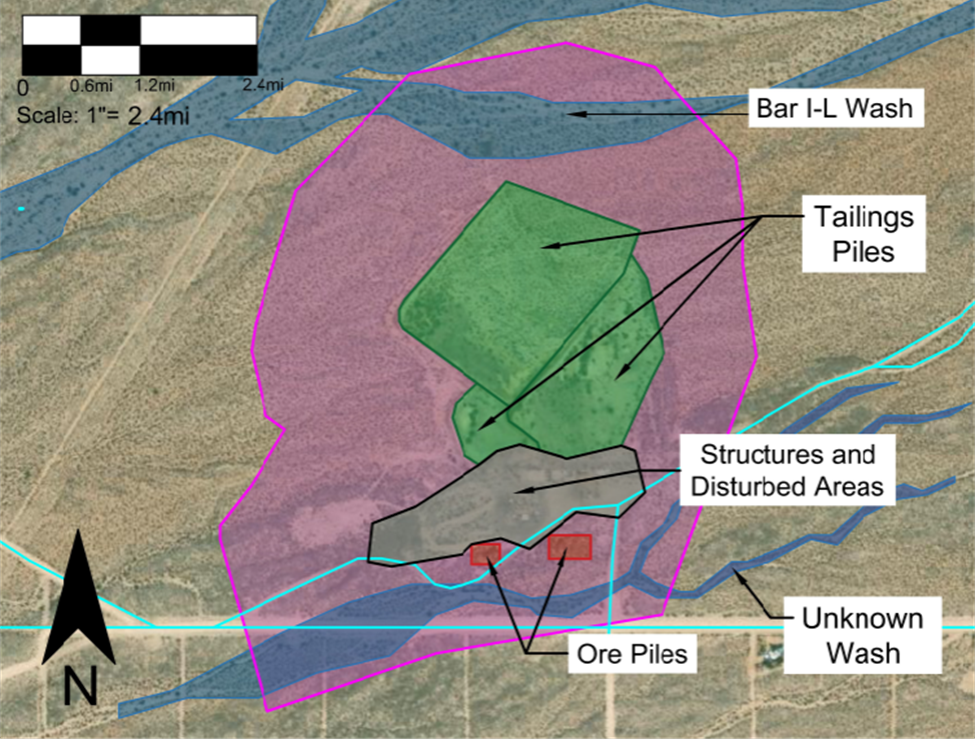

Figure 5: Site and Structures Map
Map sourced from Annika Dillemuth
Project constraints included funding for the subcontracted ICP analysis, to account for this, the team has selected 10 samples to represent the site data.
Inclement weather was a potential hazard, to account for this, the team selected backup sampling dates.
Figure 6: Yucca Plants
Photo sourced from the USDA Forest Service
The table below is an outline of the tasks needing to be completed by the project team in order to fulfill the scope of services.

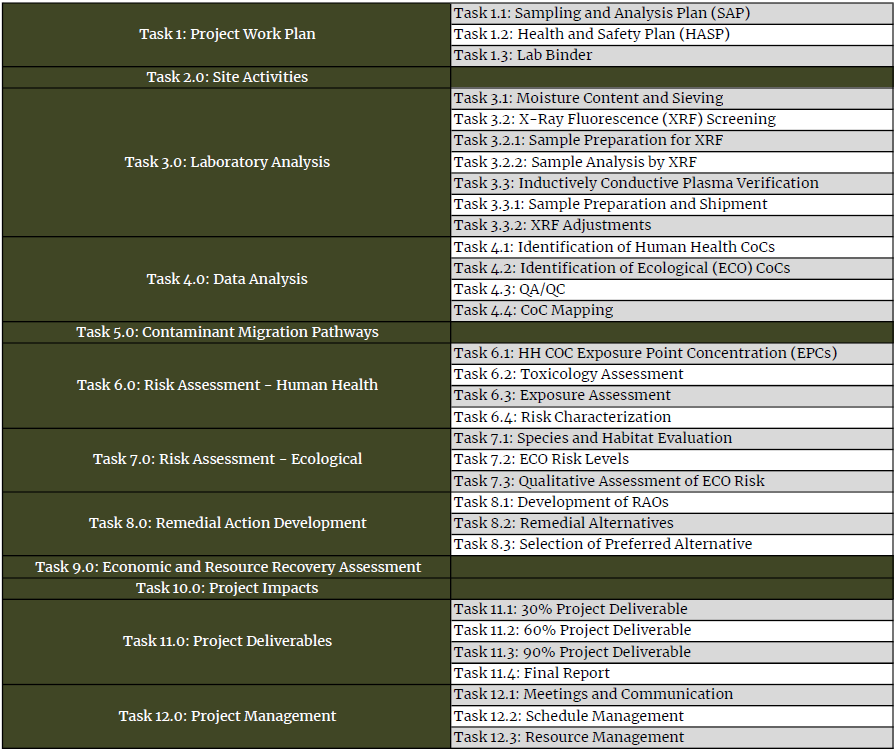

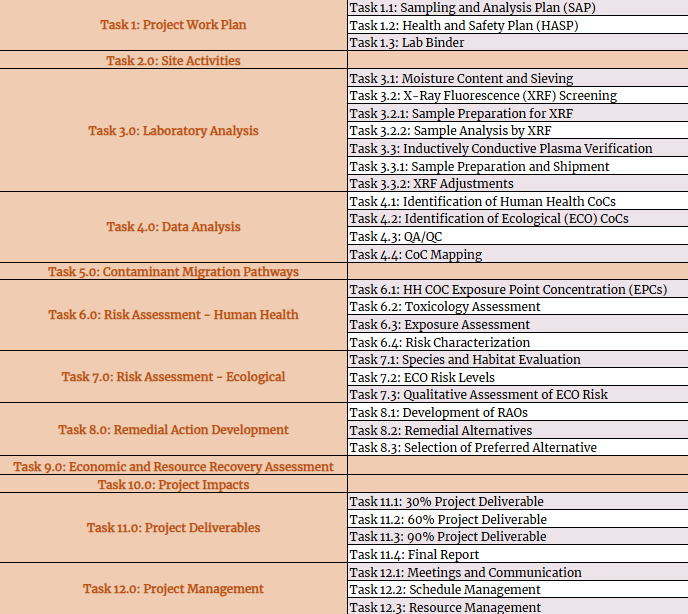

Table 1: Project Tasks
Senior Engineer
The senior engineer is the project manager, overseeing project timelines and deliverable submittals.
Requirements:
M.S. Environmental Engineering
Registered Professional Engineer
Ten Years of Experience
Engineer
The engineer will perform the bulk of the tasks and verify their work with the senior engineer.
Requirements:
B.S. Environmental Engineering
Passed Environmental Engineering Fundamentals of Engineering Exam
Applicable Experience
Lab Technician
The Lab Technician will assist in soil sampling and all laboratory analysis.
Requirements:
Lab Safety Training
Lab Certifications
Engineering Intern
The Engineering Intern will assist the Engineer wherever possible.
Requirements:
Current Environmental Engineering Student
Enrolled at an ABET Accredited University
Minimum GPA of 3.00
Have Completed 2 Years
The table below is an outline of the chargeable hours estimated for the duration of the project.

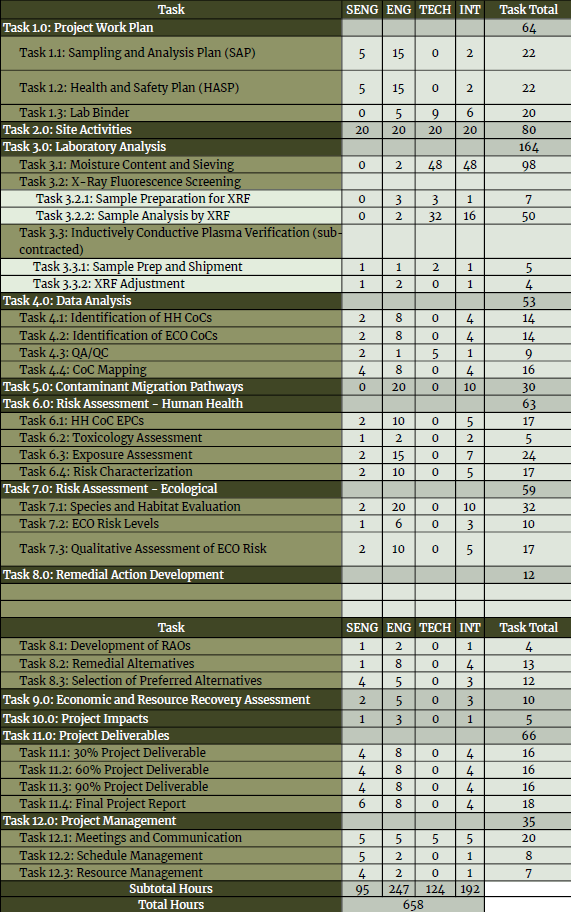

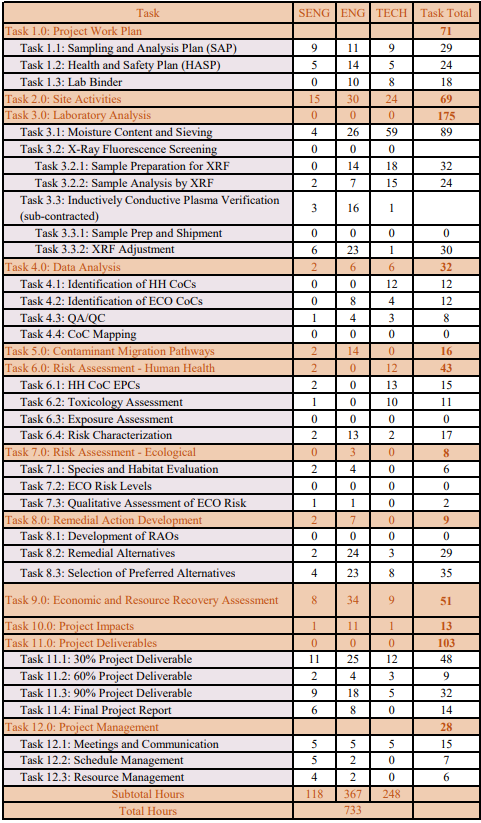

Table 2: Project Staffing Hours
The table below is the estimated cost to complete the PA/SI for the project.
This table does not include estimated costs for any remedial design alternatives.

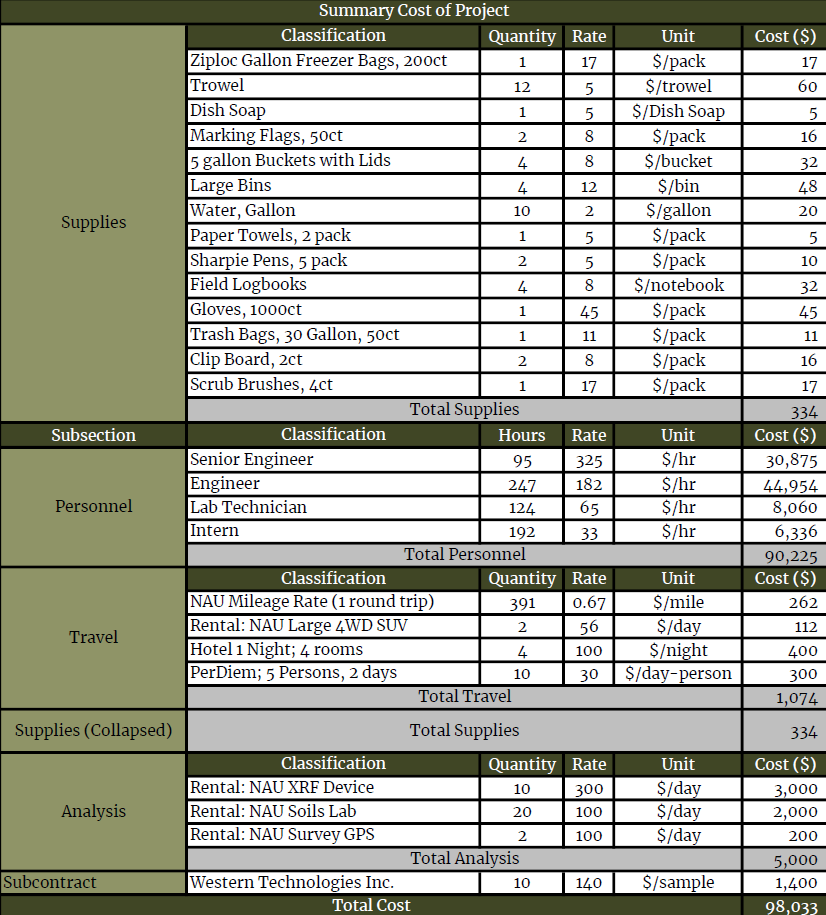

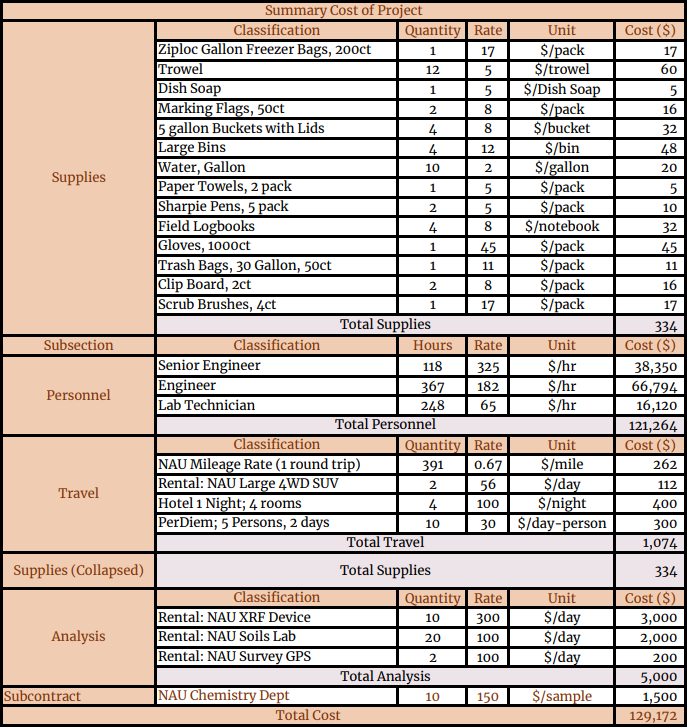

Table 3: Engineering Cost of Services
The figure below displays the project timeline. This project began on October 24, 2025 and is completed on May 5, 2026 for a total of 137 days. This timeline excludes winter break as the team did not complete work during this time.

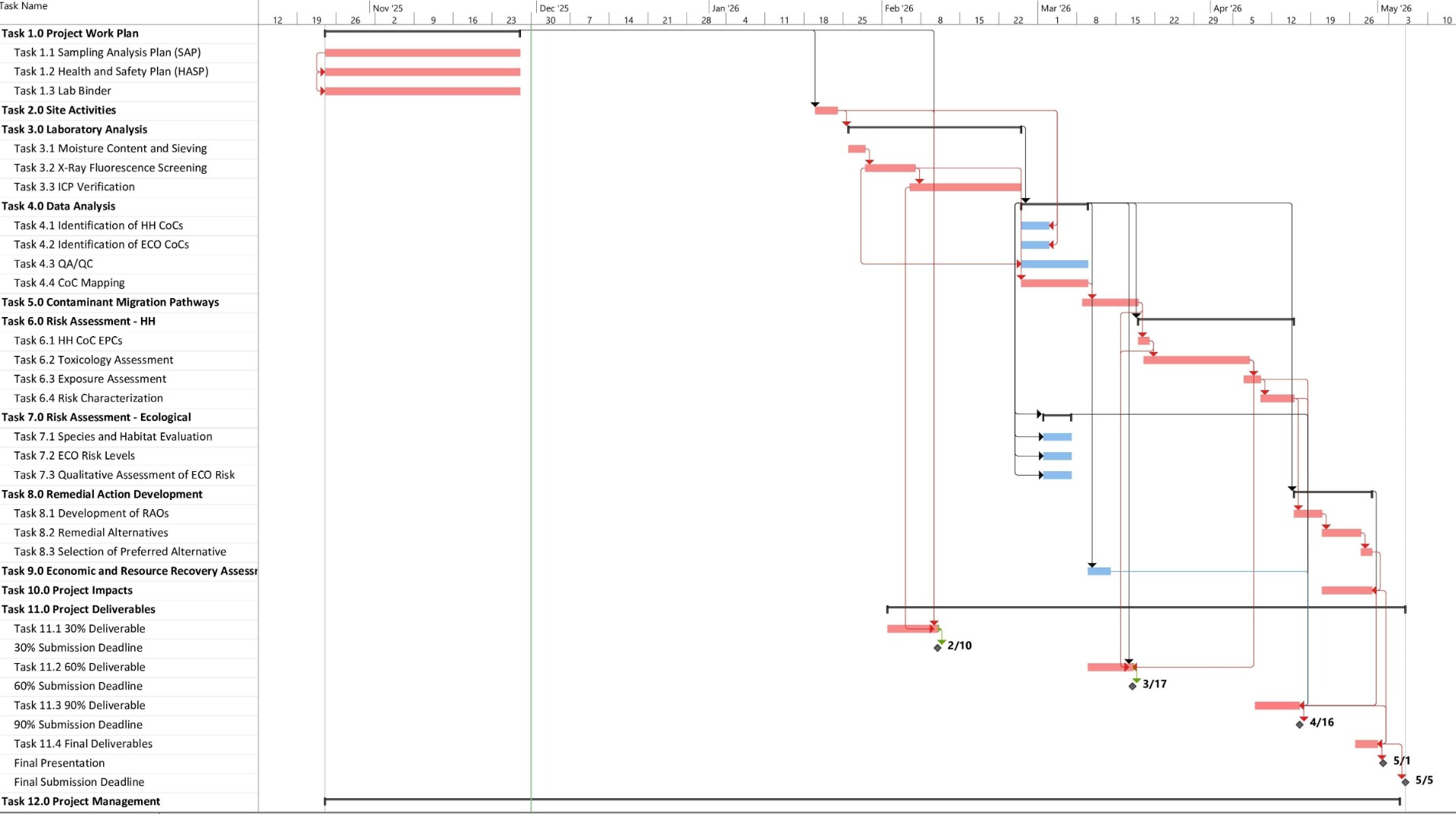

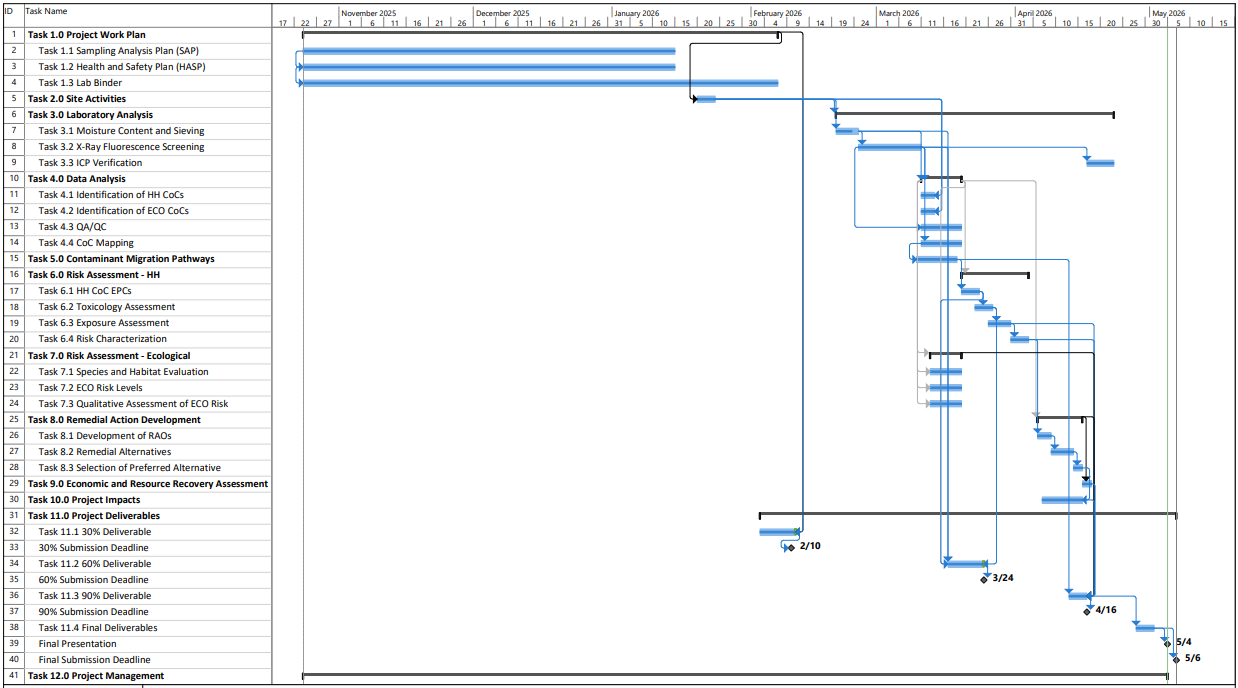

Figure 7: Project Gantt Chart
