Gantt Chart
Project Timeline: January 12th, 2026 - May 5th, 2026

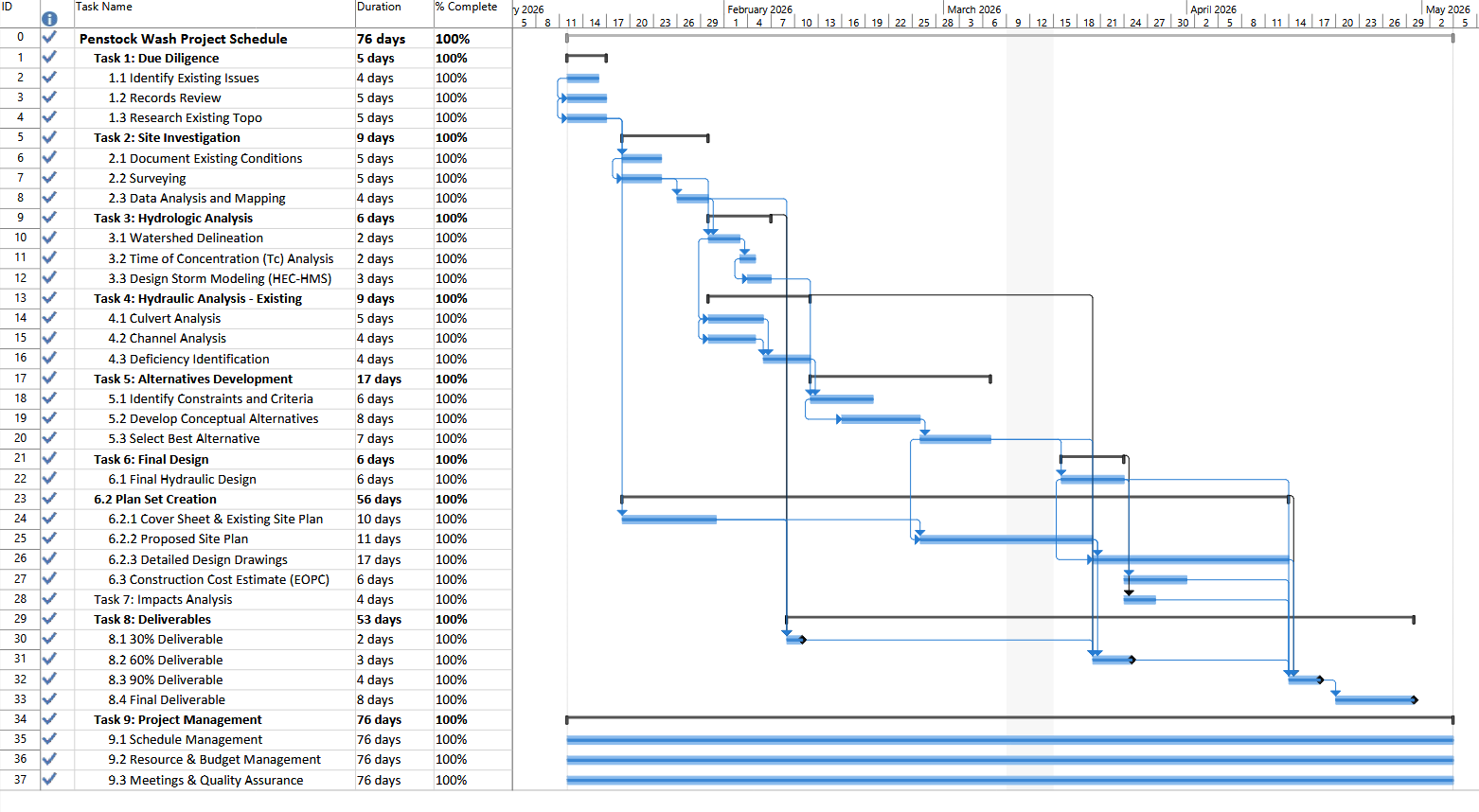

The Agua Jacks team utilized a Gantt chart to organize tasks and
time to ensure project tasks were completed on time.
Critical tasks were highlighted in red with non-critical tasks
highlighted in blue. The second image is our original, incomplete Gantt chart.
Staffing Plan

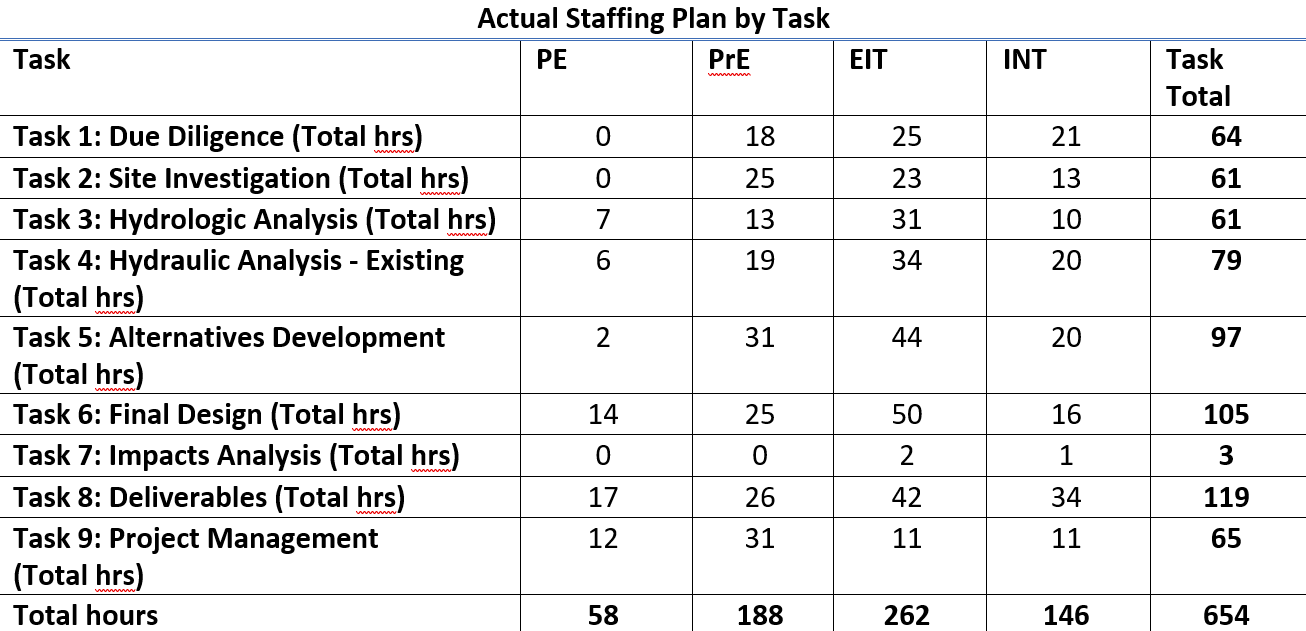

The Agua Jacks team utilized a staffing plan broken down by task to predict the work hour cost of each task. Staffing hours were tracked appropriately by task to find the actual staffing hours by task.

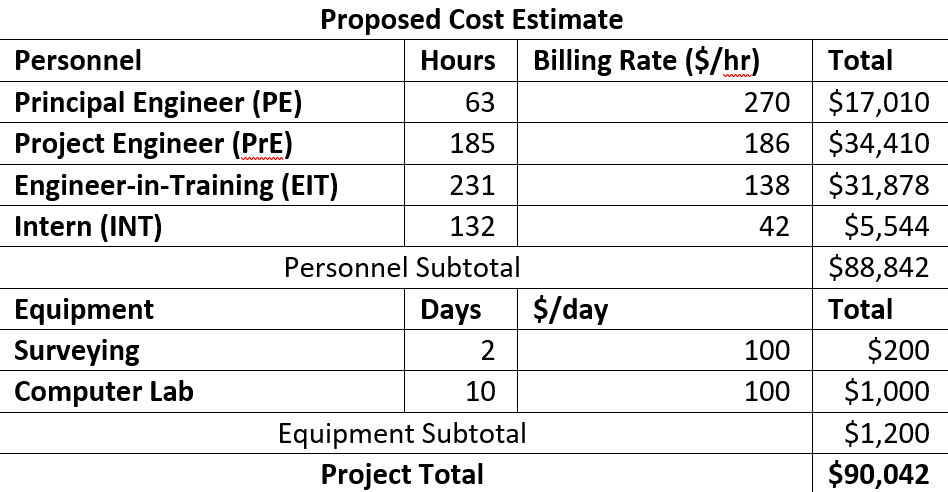

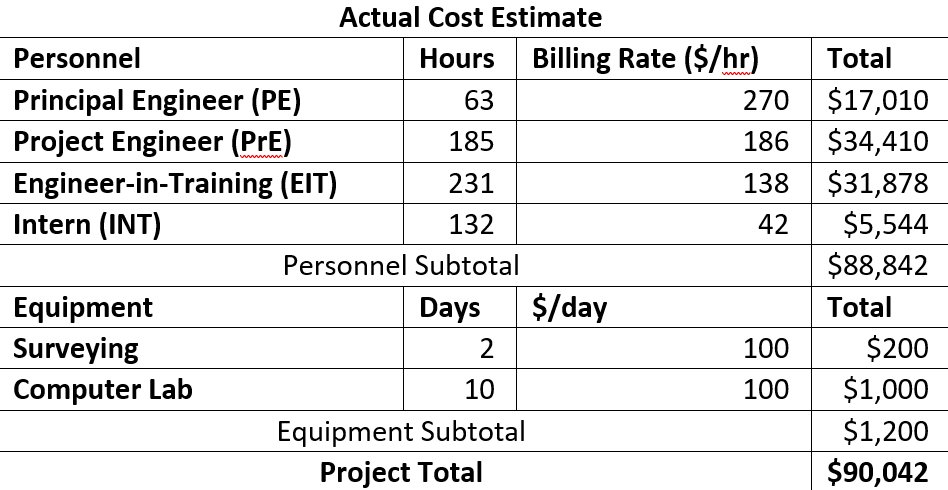

Cost of Engineering Services
The Agua Jacks team utilized a staffing plan to predict the actual cost for this project. Staffing cost was calculated using the actual work hours that the team spent.
